GuidesMarch 18, 202614 min read

From Zero to Beach Cottage: Building on Siargao for ₱1.5M

How a German expat built an 84 sqm beach cottage on Siargao for ₱1.5M. Real costs, real lessons from building Siargao's most talked-about cottage.

Finished beach cottage on a beachfront lot in Malinao, Siargao surrounded by coconut palms
₱1.5M
Total build cost, turnkey with furniture

Daniel Kipper spent ₱1.5 million building an 84 sqm beach cottage in Malinao, Siargao. Turnkey with furniture. Two bedrooms. Right on the sand. That's ₱17,900 per square meter for a finished home he can live in and rent out. But six months earlier, he was staring at a ₱2.7 million quote for the same house, minus the pool, minus the furniture. The gap between those two numbers nearly cost him his marriage, but it also taught him everything a foreigner needs to know about building on Siargao.

This is that story.

₱1.5M
Build Cost
₱17,900
Cost per sqm
84 sqm (7x12m)
Floor Area
2
Bedrooms
~2 months
Build Time
₱1.2M (44%)
Savings vs First Builder

Who is Daniel?

Daniel is a German expat who met his Filipina wife in 2010. After 15 years together and a daughter, they made the move in 2025: sell the house in Germany, build a new life in the Philippines. Before the tropics, he worked in insurance in Germany. He sold his house back home through a rent-to-own arrangement to fund the transition. He also owns a 10-meter sailing catamaran and runs Tamba-Tikki Beach House on Tambaliza island near Iloilo, a beach property that hosts vacations and weddings.

He's the kind of person who imports a used solar system on a boat across 250 kilometers of open water instead of buying new. That mentality shows up in every decision he made during this build. But none of it would have worked without his wife. She took over construction management on the ground, handling the builders, coordinating workers, and navigating the day-to-day in Filipino. Her language skills and local knowledge made her the de facto site manager for the entire project.

October 2025: The Search Begins

Daniel started looking at land in October 2025. He visited a tiny 44 sqm plot in Catangang. He checked out reference builds from a local architect/builder: a 49 sqm cottage with an outdoor kitchen for roughly ₱1.4 million (about ₱35,000/sqm without furniture). That gave him a baseline.

He eventually found a beachfront lot in Malinao, one of Siargao's quieter barangays north of General Luna. The lot is perfect for his lifestyle: direct beach access, good wind conditions for windsurfing, and far enough from the Cloud 9 crowd to keep costs reasonable.

November 2025: Lease Signed, Builder Hired

Things moved fast. On November 10, a geo-engineer surveyed the beachfront lot. Cost: about 200 euros, paid in cash, no receipt. Very Philippine. It took four attempts to get it done.

By November 18, Daniel had signed a lease: 200 sqm of land plus 200 sqm of usable foreshore. The term was 15 years with a 15-year renewal option. He'd negotiated it up from the landowner's original offer of 10 years. Monthly rent: 300 euros (roughly ₱20,000).

Pro Tip
Never sign a lease for less than 15+15 years. Some landowners on Siargao intentionally offer short terms so they can reclaim the property (and your building) when the lease expires. Daniel pushed his from 10 to 15+15. That single negotiation protects his ₱1.5 million investment for decades. Read more in our land lease guide for foreigners.

The next day, November 19, he signed a contract with a designer/builder. By November 24, the design was complete. An 84 sqm cottage, 7 by 12 meters, two bedrooms. Simple, beach-appropriate, built for island life.

Everything looked on track.

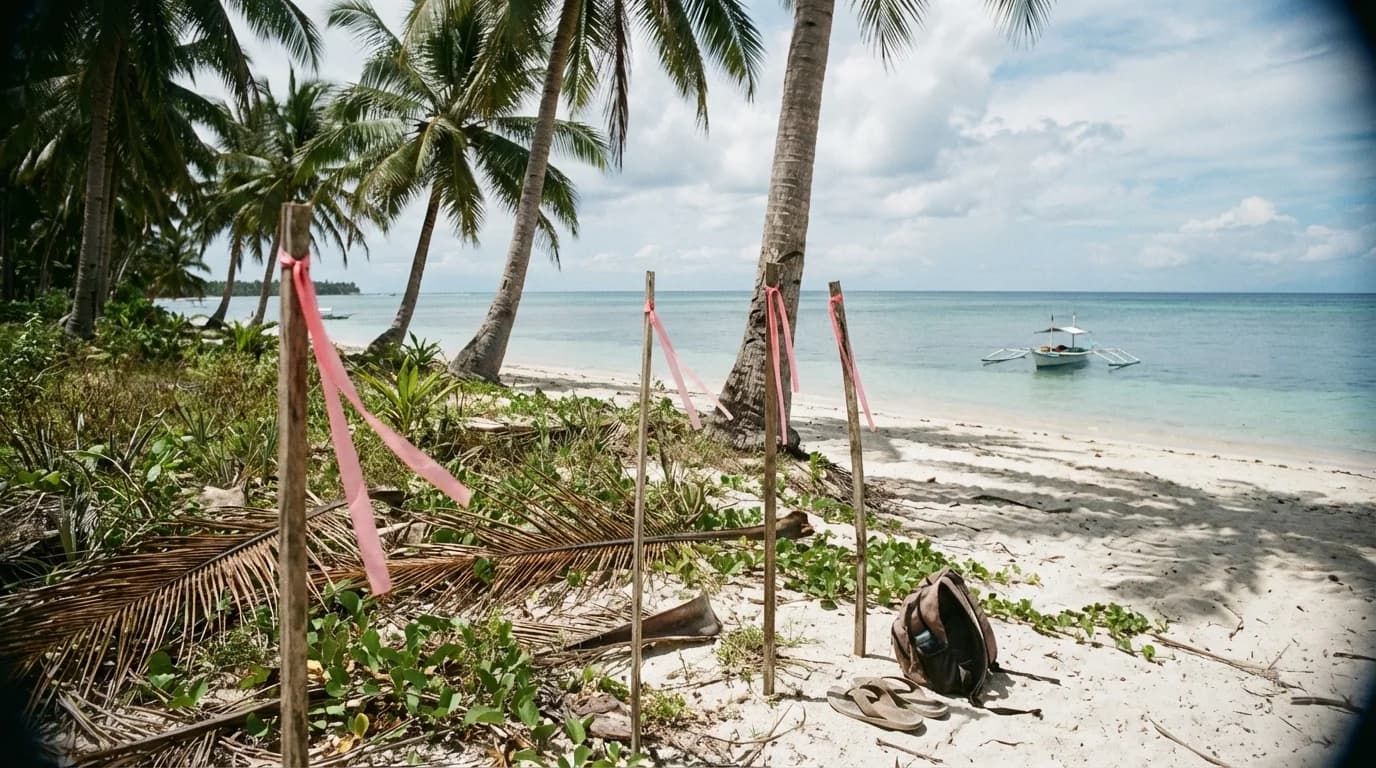

Beachfront lot in Malinao Siargao with coconut palms and white sand
Daniel's 200 sqm leased lot in Malinao, with 200 sqm of usable foreshore beyond

December 2025: The Budget Explodes

Then the numbers changed. The first builder's quote escalated from ₱1.7 million to ₱2.7 million. No pool. No furniture. Just the structure and finishing.

Daniel broke down the price creep into rough thirds:

Escalation FactorShareWhat It Means
Items missing from original quote~30%Line items that should have been included from the start
Add-ons and extras~30%Features requested after signing that stacked up fast
"Being too trusting"~30%Daniel's own words: he was too open, and the builder priced accordingly

He got a second opinion from another architect. The verdict: the original ₱1.7 million was never realistic for what had been promised. The first quote was low to get the contract signed, and the real costs were always going to surface later.

Daniel pulled the plug. He cancelled the builder contract.

That decision, made from a place of fear and financial pressure (his house sale in Germany was dragging), was the right call financially. But he made it alone.

The Crisis That Almost Ended Everything

Daniel's wife had co-planned this project from day one. When he cancelled the builder without telling her, without letting her weigh in on the decision, she saw it as a betrayal of trust. The marriage nearly ended.

His words: "I got scared and pulled out based on fear, without letting my wife co-decide."

This is the part of building on Siargao that no cost guide covers. Construction projects put real pressure on relationships, especially when one partner is from the Philippines and the other is foreign, when cultural expectations around money and family decisions don't always align. The stress of a budget doubling overnight, of being thousands of kilometers from home, of watching savings evaporate: it tests everything.

The question Daniel asked himself: do we grow from this, or do we break?

They grew.

The Turnaround: A New Builder for Less Money

Through his friend Mike, Daniel connected with a new builder who runs a crew of about 70 workers on Siargao. No fancy design office. No marketing. Just a local operation with years of completed projects behind it.

The new quote: ₱1.5 million. Turnkey. Furniture included.

That's ₱200,000 less than the original (already unrealistic) quote from builder one. And it covered significantly more scope.

DetailFirst Builder (Final)New Builder
Quote₱2,700,000₱1,500,000
FurnitureNot includedIncluded
PoolNot includedNot included
ScopeStructure + finishing onlyTurnkey with furniture
Cost per sqm₱32,100/sqm₱17,900/sqm
SourceDesigner/builder comboPersonal referral via friend
Build timeUnknown (cancelled)~2 months

The savings: ₱1.2 million. Forty-four percent. For a better result.

Builder one's ₱32,100/sqm sits close to our platform's standard tier rate of ₱36,000/sqm, which gets you full concrete construction with tiled floors and proper finishes. Daniel would have been paying standard-tier prices for cottage-quality work. Builder two delivered at ₱17,900/sqm, right at the cottage tier rate of ₱18,000/sqm, and included furniture.

The lesson from this builder comparison applies to every foreigner planning to build on Siargao. Our guide to choosing a builder breaks down exactly what to look for and what red flags to avoid.

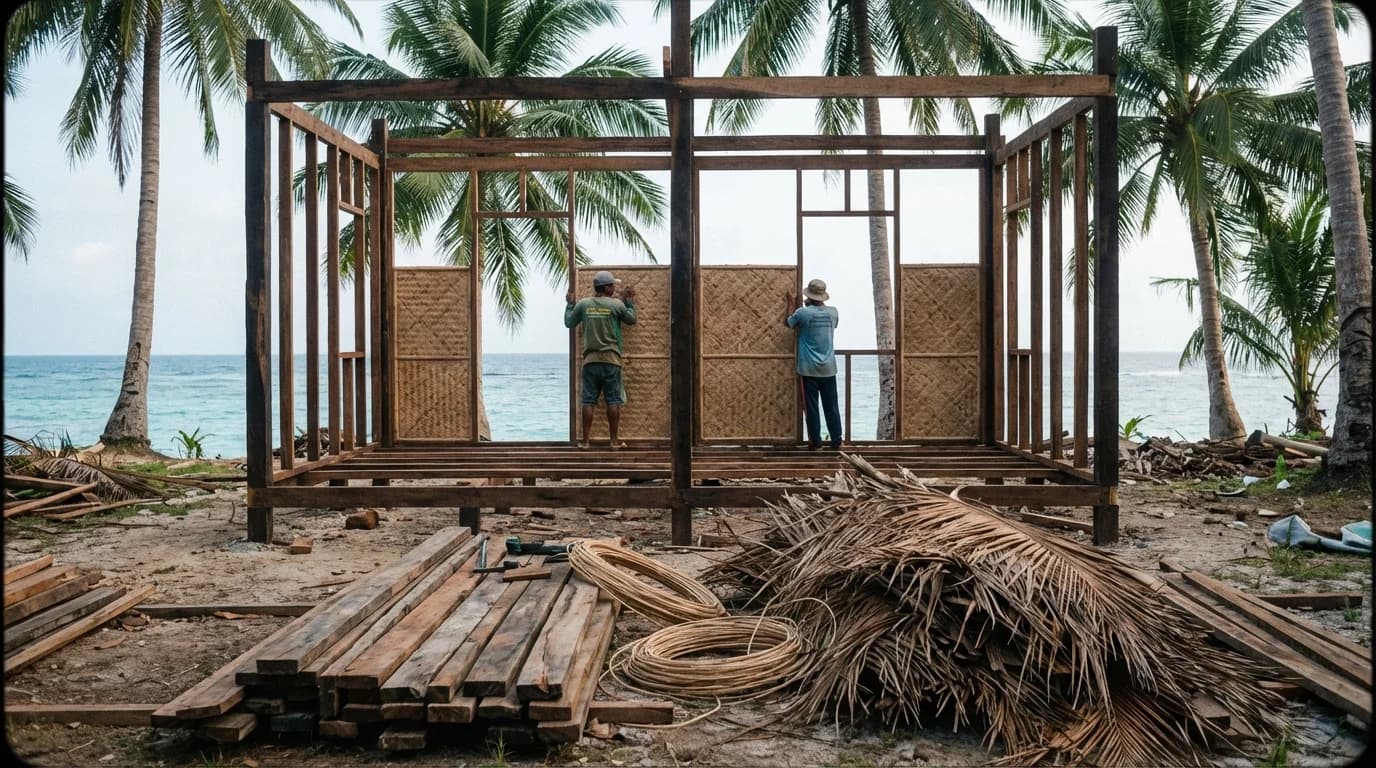

Daniel's cottage under construction in Malinao Siargao with walls going up and workers on site
Construction in full swing, February 2026. The new builder's crew had the walls up within weeks.

January to March 2026: Two Months From Ground to Home

The new builder started in January 2026. By late March, the house was finished. Roughly two months of active construction for 84 sqm. That's fast, but it lines up with what we see for cottage-tier builds on Siargao: simpler materials, less finishing work, and a large crew that can move quickly.

The timeline from start to finish:

Four months of planning and builder drama. Two months of building. That ratio is typical. The physical construction is the easy part when you've got the right team.

The Finished Cottage: What ₱1.5M Gets You

The main structure is 84 sqm with two bedrooms, fully furnished and ready to live in. But the property is more than just the house.

The House

The Extras

Infrastructure

ItemCostNotes
Deep well~₱60,000Water is relatively easy to access in Malinao
Septic tank₱10,000 to ₱30,000Separate contractor, not through the builder
Solar + battery + generatorImported usedFrom Daniel's Tambaliza project
SIARELCO grid connectionPendingApplied for, but new connections have been slow
Geo-engineer survey~₱11,000Cash, no receipt, four attempts

Daniel saved on power by importing a used solar, battery, and generator system from his Tamba-Tikki property on Tambaliza island. Not everyone has a catamaran and a second island property to pull equipment from, but the principle holds: used equipment, creative sourcing, and separating infrastructure from your main builder all cut costs. For a full breakdown of what infrastructure costs on Siargao, see our off-grid infrastructure guide.

Daniel's Monthly Math

Here's how Daniel calculates his monthly cost for beachfront living on Siargao:

ExpenseMonthly Cost
Land lease€300 (₱20,000)
Building depreciation (€25,000 over 15 years)€150
Maintenance€30
Total€480/month

Under 500 euros a month for a beachfront home. The math works because the build cost was only ₱1.5 million (~€25,000). If he'd gone ahead with builder one at ₱2.7 million, the monthly depreciation alone would have been nearly double.

The rental side adds another layer. When the family isn't using the cottage, Daniel rents it out. He sleeps in the kubu, the treehouse tent, or on his catamaran. His broader vision: living on the beach while running windsurf rentals, catamaran charters, Airbnb bookings, and even a coconut delivery service. Want to see what your own rental numbers could look like? Check our cottage Airbnb income analysis.

Completed two-bedroom beach cottage in Malinao Siargao with outdoor living area and tropical garden
The finished cottage, late March 2026. From an empty lot to a furnished beachfront home in five months.

10 Lessons from Daniel's Build

These lessons came from real mistakes, real stress, and real money saved. Every one of them applies if you're planning to build on Siargao.

1. Get a second opinion before signing anything. Daniel's builder switch saved ₱1.2 million. A second architect confirmed the original quote was unrealistic. One conversation could have prevented months of trouble.

2. Compare turnkey prices, not just base quotes. Builder one: ₱2.7M without furniture. Builder two: ₱1.5M with furniture. Same house. The scope of "what's included" matters more than the headline number.

3. Negotiate lease terms aggressively. Daniel pushed his lease from 10 years to 15+15 years. On Siargao, short leases are how landowners reclaim properties and the buildings on them. Minimum recommendation: 15+15. Read the full lease guide.

4. Budget infrastructure separately. Wells, septic tanks, solar systems, and grid connections sit on top of the construction quote. Daniel's infrastructure added roughly ₱100,000+ to his project. Our Siargao building calculator includes these costs automatically.

5. Use local networks for builder referrals. The best builder came through a friend named Mike. No website, no Google ads. Just a reputation built on finished projects. Ask expats who've already built.

6. Fix contracts clearly from the start. Daniel's "30% foreigner tax" came from being too soft in negotiations, leaving scope vague and trusting verbal agreements. Get line-item breakdowns in writing.

7. Be patient with island processes. The geo-engineer survey took four attempts. Cash payment, no receipt. That's just how things work. Budget extra time for permits, surveys, and government approvals.

8. Include your partner in every financial decision — and on the build site. This nearly cost Daniel his marriage. Big financial calls made alone, especially across cultures, can destroy trust faster than a typhoon destroys a roof. But the flip side is just as important: Daniel's wife ultimately took over construction management, coordinating the builders and handling all communication in Filipino. Without her on site, the ₱1.5M build wouldn't have come together the way it did.

9. Build time is short with the right team. 84 sqm in two months. When you've found the right builder with a large enough crew, the construction itself is the quick part. Planning takes longer than building.

10. Import used equipment to save money. Daniel shipped a solar, battery, and generator setup from Tambaliza. Even if you don't have a catamaran, sourcing used equipment from Cebu or Manila can cut infrastructure costs significantly.

Pro Tip
Daniel's experience mirrors a pattern we see across Siargao builds. The biggest risk isn't construction quality or typhoons. It's signing with the wrong builder at the wrong price. Get at least two quotes, compare them line by line, and never pay for "standard" when you're getting "cottage." Use our builder selection guide as your checklist.

Frequently Asked Questions

How much does it really cost to build a cottage on Siargao?

Daniel's 84 sqm cottage cost ₱1.5 million turnkey with furniture, which works out to ₱17,900/sqm. Our platform's cottage tier rate is ₱18,000/sqm for structure only. Expect ₱15,000 to ₱20,000/sqm for a basic cottage build, depending on your builder and design. For a full cost comparison across all quality tiers, run your numbers through our calculator.

Can a foreigner legally build a house on Siargao?

Foreigners can't own land in the Philippines, but they can lease it or set up a 60/40 corporation. Daniel leased his lot for 15+15 years at ₱20,000/month. The building itself is his property. Our foreigner guide covers the legal options in detail.

How long does it take to build a cottage on Siargao?

Daniel's 84 sqm cottage took about two months of active construction (January to March 2026). But the full process, including land search, lease negotiation, builder selection, and one builder cancellation, took about six months from start to finish. Planning always takes longer than building.

Is it worth building for Airbnb on Siargao?

It depends on your goals. Cottage-quality properties earn lower nightly rates than standard or mid-range villas (0.55x adjustment on our platform). But the build cost is also much lower. Daniel's approach is smart: live in it as a family home, rent it when you're away. For a pure investment property, standard tier typically offers better returns.

What's the biggest mistake foreigners make when building on Siargao?

Signing with the first builder who gives them a number. Daniel's experience shows the spread: ₱2.7M vs ₱1.5M for the same house. Always get at least two quotes, always compare line-item breakdowns, and always ask for referrals from other expats who've completed their builds.

What Would Your Build Cost?

Daniel's story is one data point, but the patterns are universal. Get multiple quotes. Separate your infrastructure. Lock your lease terms. Build with a clear scope and a builder who came recommended by someone you trust.

His philosophy sums it up: "It comes as it should, this way or better, for the good of all."

Try our calculator to model your own Siargao build. Plug in your floor area, quality tier, and location to get a full breakdown of construction costs, infrastructure, professional fees, and rental income projections. Or explore more build stories and guides on our blog.

You can also reach Daniel directly if you want to hear about his experience building in Malinao. He's happy to share: +63 976 340 3303 or www.tamba-tikki.de.

More from Daniel's build:

Ready to plan your build?

Get a detailed cost breakdown for your specific project in under 5 minutes.

Open Cost Calculator

Plan Your Build with a Licensed Architect

Request a consultation to discuss your project scope, site considerations, and realistic cost expectations with RJM Architect, a licensed architect in the Philippines.

RJM Architect
RJM Architect
Registered Architect · Surigao City

By submitting this form, you agree to share your contact details and project information with our local professional partner for the purpose of preparing a proposal. See our Privacy Policy and Terms of Service.

Related Articles

Choosing a Builder on Siargao (2026)How to find the right builder Siargao. One expat saved ₱1.2M by switching mid-project. Red flags, checklists, and real numbers.Land Lease on Siargao: What Foreigners Need to KnowReal land lease Siargao costs by location, contract terms, and legal tips from an expat who's done it.
