CostsMarch 23, 202610 min read

Real Building Costs on Siargao: A ₱1.5M Case Study

Actual building costs Siargao from a real 84 sqm cottage build. ₱17,900/sqm turnkey with furniture, plus builder comparison.

Completed cottage on a beachfront lot in Malinao, Siargao Island
₱17,900/sqm
Daniel's actual build cost (turnkey with furniture)

Daniel Kipper, a German expat who met his Filipina wife in 2010 and moved to the Philippines in 2025, built an 84 sqm two-bedroom cottage in Malinao, Siargao for ₱1.5 million. Turnkey. Furniture included. That's ₱17,900 per square meter, which sits just below our platform's cottage tier rate of ₱18,000/sqm. But the number he almost paid? ₱2.7 million. Same house, no pool, no furniture. The difference between those two numbers is a story every foreigner planning to build on Siargao should hear.

₱1.5M
Final Build Cost
₱17,900
Cost per sqm
84 sqm
Floor Area
₱1.2M (44%)
Savings vs First Builder

How Building Costs Escalated from ₱1.7M to ₱2.7M

Daniel signed with his first builder in November 2025. The initial quote came in at ₱1.7 million for an 84 sqm cottage. Reasonable enough. By December, that number had grown to ₱2.7 million, and the scope hadn't improved. No pool. No furniture. Just the structure and finishing.

Daniel got a second opinion from another architect. The verdict: ₱1.7 million was never realistic for what was promised. The original quote was too low to begin with.

So what happened? Daniel breaks it down into thirds:

Cost Escalation FactorShareWhat It Means
Items not included in original quote~30%Line items that should have been in the first estimate but weren't
Add-ons and extras~30%Features Daniel requested after signing, which added up fast
"Foreigner tax" (being too trusting)~30%Daniel's own words: "I was too soft, too open, and he thought he could milk me"

This pattern isn't unique to Daniel. We see it across Siargao builds. An initial quote comes in low, either because the builder genuinely underestimates or because a low number gets the contract signed. Then costs creep up once work has started and switching builders feels painful.

Pro Tip
Always ask for a line-item breakdown before signing. If the quote is a single lump sum without detail, that's your first red flag. A real builder can tell you exactly what concrete, rebar, roofing, labor, and finishing will cost separately.

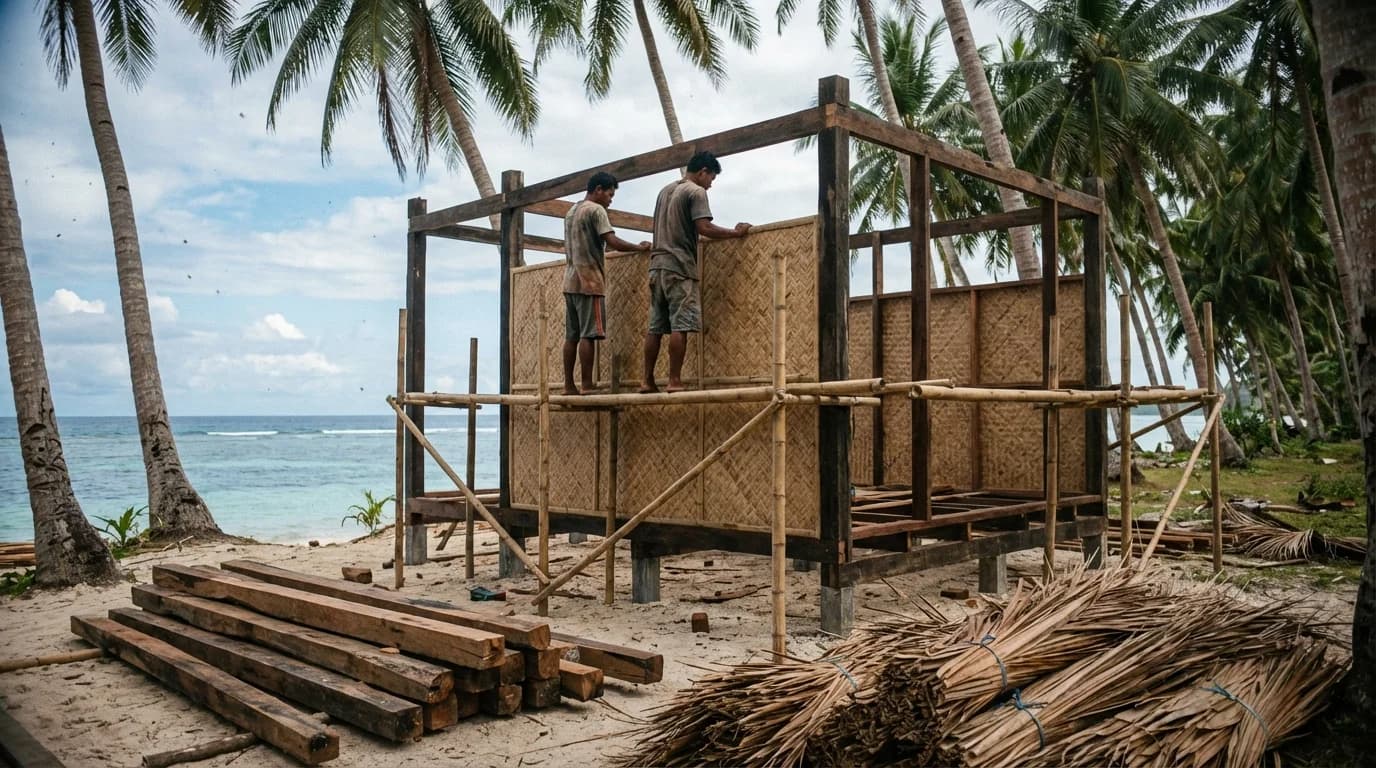

Cottage under construction in Malinao, Siargao with walls going up
Daniel's cottage during construction in February 2026, roughly six weeks into the build

The Builder Switch That Saved ₱1.2 Million

Daniel cancelled the first builder's contract in December 2025. It wasn't easy, and it created real stress at home. But his wife ultimately stepped in as construction manager for the second build, handling all communication with the crew in Filipino and keeping the project on track. But through his friend Mike, he connected with a new builder who runs a team of about 70 workers on Siargao.

The new builder's quote: ₱1.5 million. Turnkey. Furniture included. That's less than the original ₱1.7 million quote from builder one, and it covered significantly more scope.

First Builder (Final)New Builder
Quote₱2,700,000₱1,500,000
FurnitureNot includedIncluded
PoolNot includedNot included
ScopeStructure + finishing onlyTurnkey with furniture
Cost per sqm₱32,100/sqm₱17,900/sqm
SourceDesigner/builder comboBuilder via personal referral
Build TimeUnknown (cancelled)~2 months

The math is stark. Builder one's final price of ₱32,100/sqm for a cottage without furniture sits closer to standard tier pricing (₱36,000/sqm), which gets you full concrete construction with tiled floors and proper finishes. Daniel would have been paying standard prices for cottage quality.

Builder two came in through a personal referral. No fancy marketing, no design office. Just a local builder with a large crew and low overhead. That's how you get ₱17,900/sqm on Siargao.

Where ₱17,900/sqm Fits on the Price Scale

Siargao construction costs vary widely by quality tier. Here's how Daniel's build compares to the standard rates we track across the island:

Quality TierRate per sqm84 sqm BuildDescription
Daniel's Cottage₱17,900₱1,500,000Turnkey with furniture
Cottage (platform rate)₱18,000₱1,512,000Basic native-style, open-air design
Standard₱36,000₱3,024,000Concrete, tiled floors, proper fixtures
Mid-Range₱45,000₱3,780,000Better materials, imported fixtures
High-End₱65,000₱5,460,000Architect-designed, premium throughout

Daniel's ₱17,900/sqm lands right at the cottage tier, which makes sense for the build type: a two-bedroom beach house with a practical, island-appropriate design. The fact that it includes furniture makes the number even more impressive. Most cottage-tier quotes are structure only.

For context, a cottage-quality property on Airbnb earns at a 0.55x adjustment compared to a standard villa. That's a real trade-off if you're building primarily for rental income. But for Daniel, this is a family home first. Rental income is secondary, something he'll do when the family is away.

Want to see what your own build would cost at each tier? Run your numbers through our calculator to get a full breakdown.

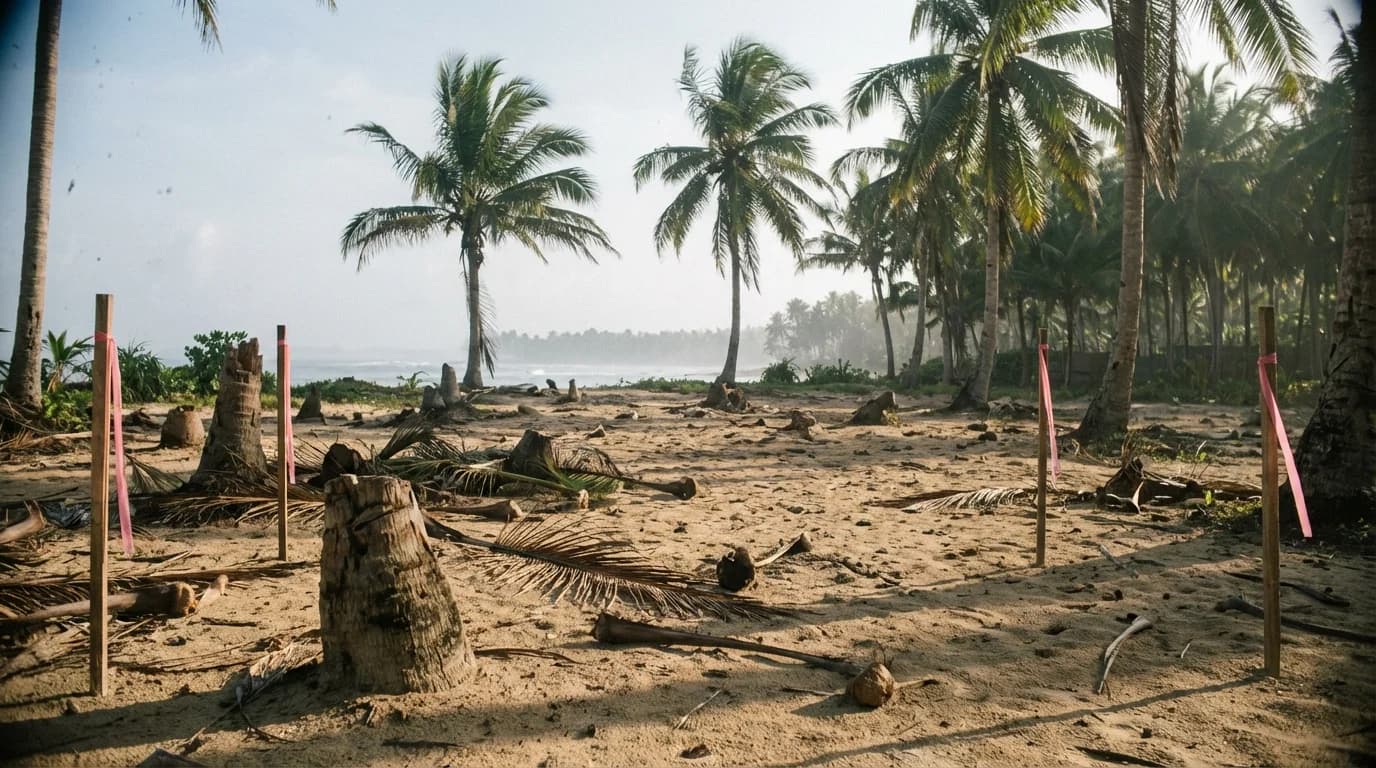

Beachfront lot in Malinao, Siargao with coconut palms
Daniel's 200 sqm leased lot in Malinao, plus 200 sqm of usable foreshore

The Full Project Cost Picture

The ₱1.5 million covers the house itself. But a complete build on Siargao always involves more than just construction. Here's what Daniel's total project looks like:

ItemCostNotes
Construction (turnkey + furniture)₱1,500,00084 sqm, 2BR cottage
Deep well~₱60,000Water is relatively easy to access on Siargao
Septic tank₱10,000 to ₱30,000Handled by a separate contractor
Land survey (geo-engineer)~₱11,000Took 4 attempts, cash payment, no receipt
Solar + battery + generatorImported usedFrom Daniel's other project on Tambaliza
SIARELCO grid connectionPendingApplied for, but SIARELCO has been slow with new connections
Land lease (monthly)₱20,000/month (~€300)200 sqm, 15+15 year term

Infrastructure costs like wells, septic systems, and power sit on top of the construction number. Our hidden costs guide covers these in detail. Daniel saved on power by importing a used solar, battery, and generator setup from his previous project on Tambaliza island. Not everyone has that option, but it shows how creative sourcing can cut costs.

Pro Tip
Get infrastructure quotes from separate contractors, not through your builder. Daniel's well and septic came from independent workers and cost a fraction of what a bundled builder quote would have been. On Siargao, specialists are cheaper than generalists for specific jobs.

Build Timeline: 2 Months Start to Finish

One detail that surprises people: Daniel's 84 sqm cottage went from ground-breaking to near-completion in about two months (January to March 2026). That's fast, even by Siargao standards.

Our platform estimates a 0.9x timeline multiplier for cottage builds, meaning they're roughly 10% faster than standard construction. Daniel's experience confirms this. Simpler structures with less finishing work just move quicker, especially when the builder has a large crew available.

The full timeline looked like this:

Two months of actual construction. Four months of everything else. That ratio is typical. Planning, permits, builder selection, and land negotiations eat more time than the physical build.

Finished two-bedroom cottage on Siargao island with tropical surroundings
The finished cottage, ready for move-in by late March 2026

Five Lessons from Daniel's Build

1. Get a second opinion before it's too late. Daniel's builder switch saved ₱1.2 million. That's 44% of the inflated price. A second opinion from another architect confirmed the original quote was unrealistic. If someone had told him that before he signed, the entire crisis could have been avoided.

2. Personal referrals beat advertising. The builder who delivered at ₱1.5M came through a friend. No website, no marketing budget, just a reputation built through completed projects. Ask other expats who they've used. Check the finished work in person.

3. Separate your infrastructure contracts. Well drilling, septic tanks, and electrical connections don't need to go through your main builder. Hiring specialists directly is almost always cheaper.

4. Lock your lease terms. Daniel negotiated his lease from 10 years to 15+15 years. Short leases are common on Siargao, and some landowners use them to reclaim properties (and the buildings on them) after the term expires. Minimum recommendation: 15+15 years.

5. Budget for the unexpected. Daniel's 30/30/30 breakdown (items not quoted, add-ons, being too trusting) is worth memorizing. If you're planning a build, add 20 to 30 percent to any initial quote as a contingency buffer.

Frequently Asked Questions

How much does it cost to build a cottage on Siargao per square meter?

Daniel's build came in at ₱17,900/sqm turnkey with furniture. Our platform's cottage tier rate is ₱18,000/sqm for structure only. Expect to pay between ₱15,000 and ₱20,000/sqm for a basic cottage build, depending on your builder and location. For a comparison across all quality tiers, see our cost guide.

Can you really build a house on Siargao for under ₱2 million?

Yes. Daniel built 84 sqm with two bedrooms and full furnishing for ₱1.5 million. The key was finding the right builder through a personal referral and keeping the design simple. Cottage-tier construction at this price point is achievable, but you need competitive quotes and a clear scope of work.

How long does it take to build a cottage on Siargao?

Daniel's 84 sqm cottage took about two months of active construction (January to March 2026). Cottage builds are roughly 10% faster than standard construction because they involve simpler materials and less finishing work. Planning, permits, and builder selection will add another two to four months before construction starts.

Why do building costs vary so much between builders on Siargao?

Several factors drive the spread: builder overhead (a large crew with low admin costs vs. an architect-builder combo), transparency in quoting (line-item vs. lump sum), and how the builder prices in risk. Daniel saw a 44% difference between two builders for the same project. Always get at least two quotes and compare them line by line.

Is it worth building cottage quality for Airbnb on Siargao?

It depends on your target market. Cottage-quality properties earn at a 0.55x rate adjustment compared to standard villas. That means lower nightly rates and a longer payback period. For a primary residence with occasional rental, like Daniel's setup, cottage quality makes perfect sense. For a pure investment property, standard tier offers better returns.

What Would Your Build Cost?

Daniel's story is one data point. Your project will have different specs, a different location, and different priorities. But the patterns hold: get multiple quotes, separate your infrastructure, and build with a clear scope.

Try our calculator to model your own build. Plug in your floor area, quality tier, and location to see a full cost breakdown, including infrastructure, professional fees, and rental income projections.

You can also reach Daniel directly if you want to hear more about his experience building in Malinao. He's happy to share: +63 976 340 3303 or www.tamba-tikki.de.

Ready to plan your build?

Get a detailed cost breakdown for your specific project in under 5 minutes.

Open Cost Calculator

Plan Your Build with a Licensed Architect

Request a consultation to discuss your project scope, site considerations, and realistic cost expectations with RJM Architect, a licensed architect in the Philippines.

RJM Architect
RJM Architect
Registered Architect · Surigao City

By submitting this form, you agree to share your contact details and project information with our local professional partner for the purpose of preparing a proposal. See our Privacy Policy and Terms of Service.

Related Articles

Villa Construction Cost on Siargao (2026)Real construction rates per sqm on Siargao. Cottage to luxury tier pricing with timeline estimates.
